Spring Irrigation Startup Checklist

Spring startup should be a controlled inspection, not a full-pressure surprise. Winter damage, loose fittings, clogged filters, shifted heads, and controller errors are easier to correct when water is restored gradually and zones are tested one at a time.

Inspect before restoring water

Check exposed backflow assemblies, filters, timers, regulators, valve boxes, controller enclosures, and pump equipment for cracks, missing caps, rodent damage, or water intrusion. Confirm that drains and removable winter components are closed or reinstalled correctly.

Restore pressure slowly

Open the irrigation supply gradually while watching the main connection, backflow device, and valve boxes. Stop if water appears where it should not, if a relief port discharges continuously, or if pressure cannot stabilize.

Do not start a pump against a closed or uncertain system. Follow pump and pressure-equipment startup instructions.

Test one zone at a time

Run each zone manually and observe heads, emitters, valve operation, controller response, and the far end of the run. Check for leaks, clogged outlets, poor arcs, runoff, and zones that remain on after shutdown.

Startup finding First response
Wet valve box Isolate the zone and inspect before burying or closing access.
Weak far heads Check filter, pressure, leaks, and zone flow.
Water on pavement Adjust arc, level, and nozzle before adding runtime.
Controller time is wrong Correct clock and programs before automatic operation.

Set the first schedule from conditions

Begin conservatively and adjust after checking soil moisture, rainfall, plant stage, and weather. A spring schedule should not copy a hot-weather program. Verify rain-sensor status and seasonal adjustment before enabling automatic watering.

Startup checklist

    • Inspect exposed components before restoring water.
    • Pressurize slowly and stop for leaks or unstable pressure.
    • Test each zone manually, including the farthest outlet.
    • Correct controller time, sensor status, and seasonal adjustment.
    • Record repairs and reassess schedule after several cycles.

    What to verify for this topic

    For this subject, begin with winter damage, valve boxes, filters, pressure, controller time, sensors, and first-cycle observations. Those details determine whether the next step is a schedule adjustment, a cleaning or repair task, a design change, or a request for qualified service. Do not infer a cause from one visual clue. Compare the affected area with a normal area, and compare the start of the run with the far end when water travels through a line.

    The safe boundary is to restore the system gradually and keep automatic watering disabled until every zone has passed a controlled manual check. If the system cannot be isolated, the measurement cannot be trusted, or the proposed action would change a regulated connection, leave the equipment in a safe state and document the condition for the person who will complete the work.

    Work through the decision in a repeatable order

    The most useful way to apply this guidance is to separate observation, measurement, adjustment, and verification. Start by writing down the current symptom and the part of the system affected. Then identify the water source, the zone or component involved, and any recent change such as a repair, new planting, weather event, fertilizer application, or controller reset. This prevents a familiar-looking symptom from being treated with the wrong fix.

    Use one controlled change at a time. If you change a nozzle, runtime, pressure setting, filter, sensor threshold, or pipe route, record the change before testing again. When several variables are changed together, it becomes difficult to tell whether the improvement came from the repair or whether a new problem was introduced. A short written record is usually enough: date, zone, starting condition, measurement, change made, and result.

    Stage What to record What a useful result looks like
    Observe Location, timing, weather, recent work, and affected plants or equipment The symptom can be reproduced or described precisely
    Measure Pressure, flow, moisture, runtime, output, or equipment status as relevant The measurement is taken at a comparable point each time
    Adjust One repair, setting, cleaning step, or schedule change The change addresses a plausible cause, not only the visible symptom
    Verify Near and far points, startup and shutdown, and the next normal cycle Water reaches the intended root zone without unsafe behavior or waste

    Use the field check before buying parts

    Before replacing equipment, inspect the simplest causes that fit the symptom. Confirm that the correct valve, filter, sensor, controller program, shutoff, or power source is being tested. Look for leaks, clogged outlets, damaged insulation, unusual pressure change, runoff, standing water, or a setting that was changed during earlier work. A replacement part cannot correct an undersized zone, a blocked filter, a bad route, or a schedule that does not match the site.

    For a meaningful comparison, test under normal operating conditions. A pressure reading with every zone closed may not describe the pressure while the zone is running. A soil check at the surface may not describe the moisture at root depth. An app status may not prove that a valve opened. Repeat the check at representative near, middle, and far points whenever the system has a long run or different elevations.

    Know when to pause

    Stop the work when water can reach a drinking-water line, when an electrical enclosure or pump circuit is wet or energized, when excavation reaches an unknown utility or obstruction, when a pressurized component cannot be isolated, or when a repair would require bypassing a safety device. Also pause when the proposed change could create runoff toward a building, road, drain, well, or neighboring property. Keep the system in its safest known state and obtain qualified local guidance where code, licensing, testing, or equipment instructions apply.

    Keep a small maintenance record

    Save the model numbers, zone names, photos, measurements, settings, repair dates, and next review date. Note what did not work as well as what did. This record helps a future technician start with evidence, supports seasonal adjustments, and makes it easier to notice a gradual decline in flow or coverage. Recheck the system after major weather, landscaping, water-source, controller, or equipment changes.

    Practical close-out checklist

    • Write the symptom and the affected zone or component before changing anything.
    • Measure under normal operating conditions and compare representative locations.
    • Make one controlled change and record the date, setting, or part used.
    • Run a verification cycle and inspect both the source side and the far end.
    • Pause for electrical, potable-water, utility, pressure, structural, or code uncertainty.

    References

    These sources provide general water-efficiency, irrigation-management, controller, drip-irrigation, and backflow context. Local plumbing, electrical, water-use, excavation, and landscape rules can be stricter; manufacturer instructions and the applicable local authority control the final decision.

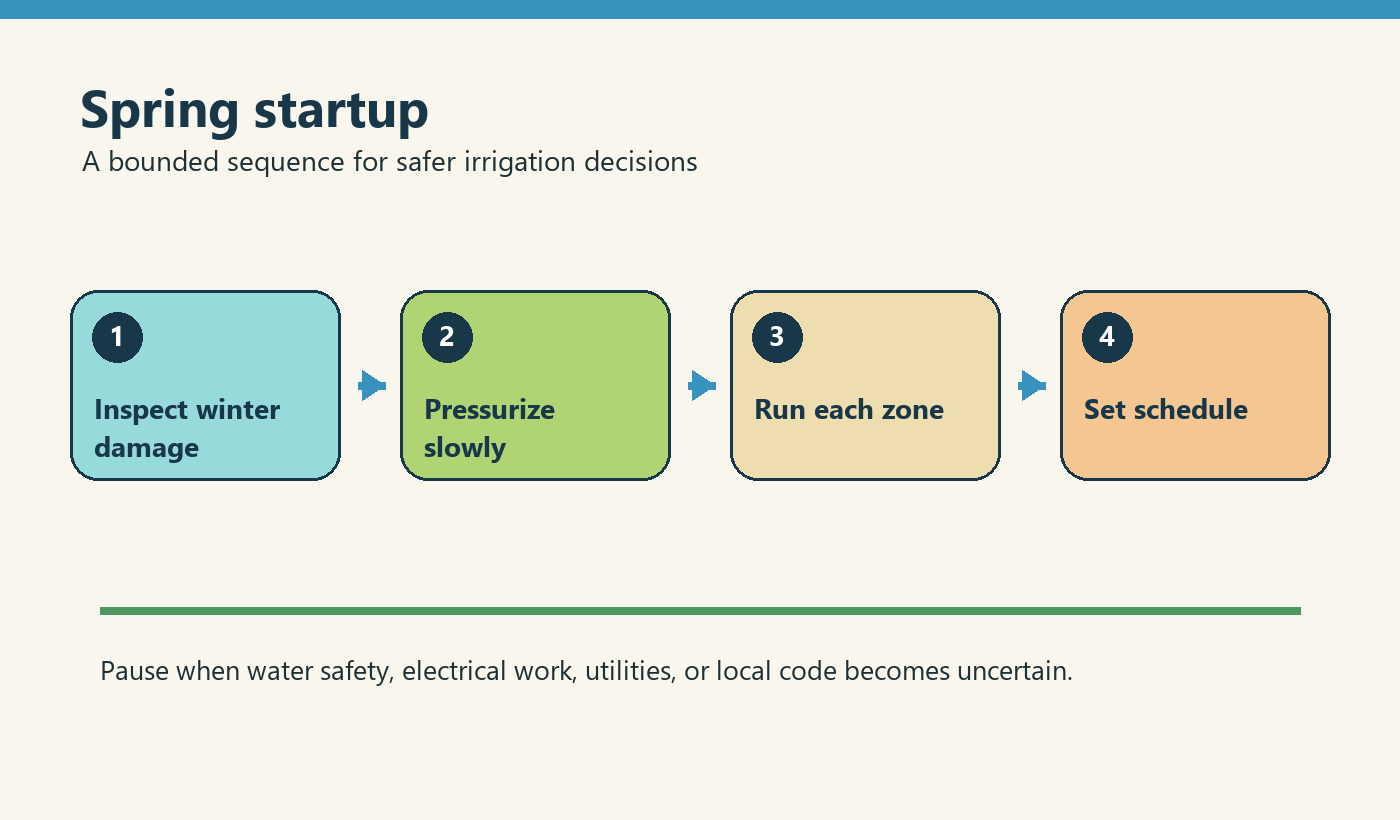

    Four-step flow diagram: spring startup
